July Report
- Report Date
- July 2013

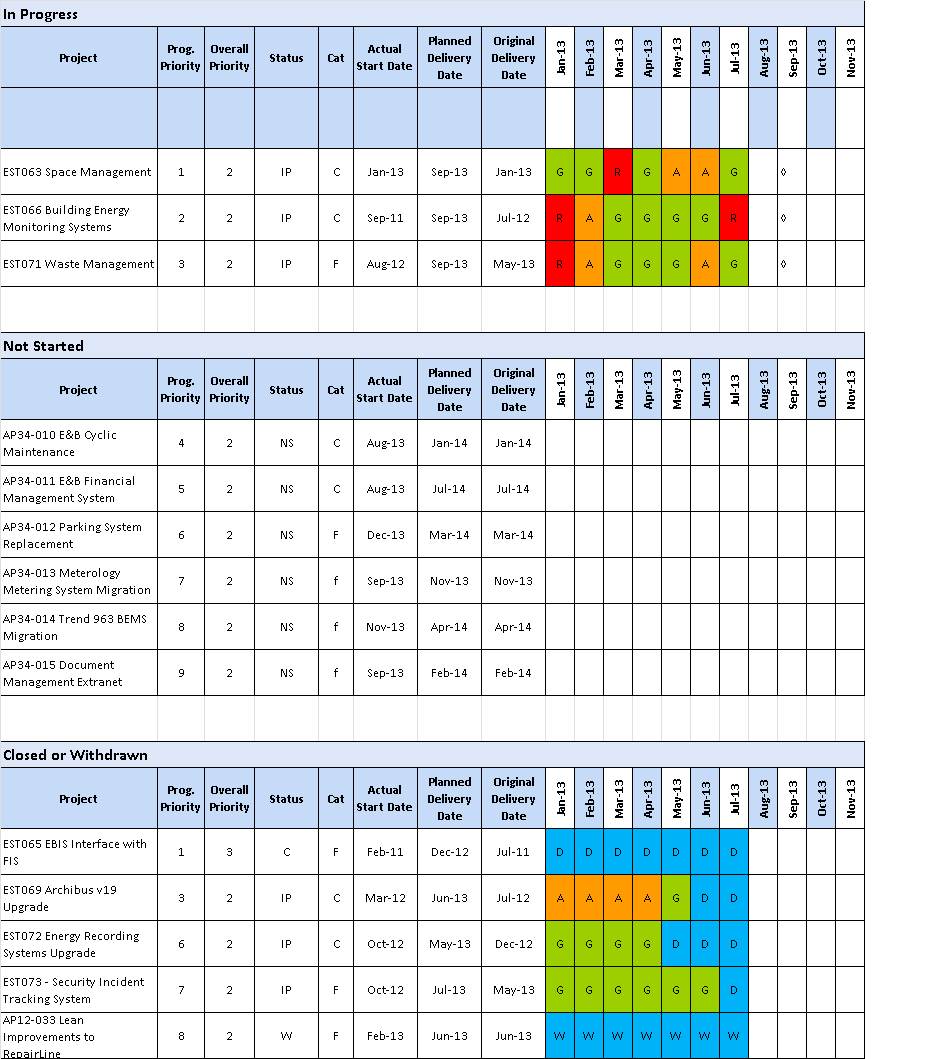

Section One: Programme Commentary, RAG and Resources Update
Section Two: Projects Not Started
Section Three: Projects In Progress
Section Four: Closed or Withdrawn Projects
Section One: Programme Commentary, RAG and Resources Update
During this month, the Securtity Incident Tracking project (EST073) has been closed. Whilst good progress continues to be made on the Space Management project (EST063), unexpected issues have been encountered on both the Buiding Energy Monitoring System (EST066) and the Waste Mangement System project (EST071).

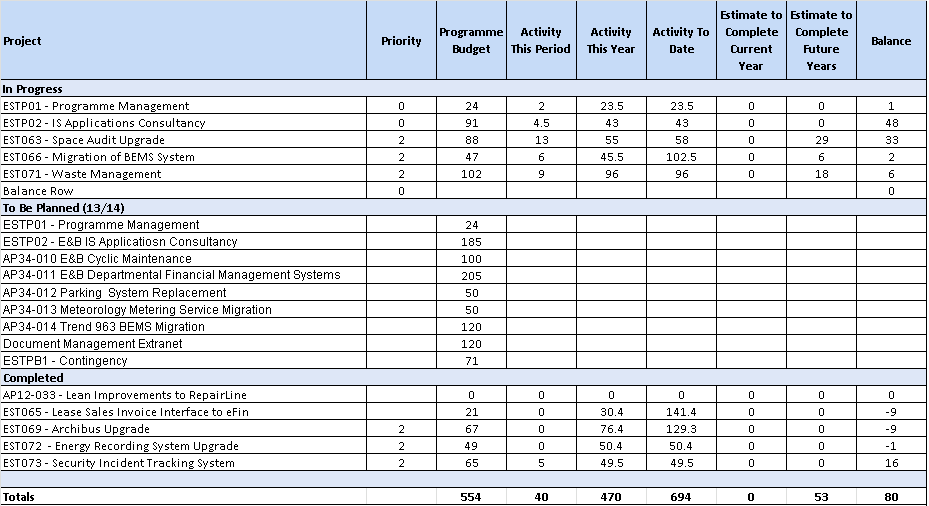

During July, 40 days resource was utilised which equates to a burn rate of 73%. The overall burn rate for the year was calculated at 84%
At the end of 12/13, there will be the requirement to carry forward the foillowing projects into 13/14 EST063 - Space Management with an estimated carry over of 29 days (funded) EST066 - Buiding Energy Monitoring System with an estimated carry over of 6 days (core funded) EST071 - Waste Management System with an estimated carry over of 18 days (funded)
The project manager will discuss with the programme owner how to incorporatre the assitional unplanned carry over within the programe budget for 13/14.
The programme budget listed for 13/14 states.
ESTP01 - Programme Management - 24 days (no change on last year)
ESTP02 - E&B IS Applicatiosn Consultancy - 185 days
AP34-010 E&B Cyclic Maintenance - 100 days
AP34-011 Estates and Buildings Departmental Financial Management Systems - 205 days
AP34-012 Parking System Replacement - 50 days
AP34-013 Meteorology Metering Service Migration - 50 days
AP34-014 Trend 963 BEMS Migration - 120 days
AP34-015 Document Management Extranet - 120 days
ESTPB1 - Contingecy balance row - 71 days


Section Two: Projects Not Started
| Project Info | Programme Managers Commetary |
AP34-010 E&B Cyclic Maintenance Compliant Planning: August 2013 Delivery: Januaryu 2014 | Plan Project scheduled to commence August 13/14 Dependancies |
AP34-011 E&B Financial Management - Phase 1 Compliant Planning: August 2013 Delivery: July 2014 | Plan Project scheduled to commence August 13/14 Dependancies |
AP34-015 Document Management Extranet Funded Planning: September 2013 Delivery: February 2014 | Plan Project scheduled to commence September 13/14 Dependancies |
AP34-013 Meterology Metering System Migration Funded Planning: September 2013 Delivery: November 2013 | Plan Project scheduled to commence September 13/14 Dependancies |
AP34-014 Trend 963 BEMS Migration Funded Planning: November 2013 Delivery: April 2014 | Plan Project scheduled to commence November13/14 Dependancies |
AP34-012 Parking System Replacement Funded Planning: December 2014 Delivery: March 2014 | Plan Project scheduled to commence December 13/14 Dependancies |
Section Three: Projects in Progress
| Project Info | Project Managers Commentary | ||||||||||||
EST063 (AP23-010) Space Audit Upgrade Category: Compliance Milestones
RAG Status GREEN | Report by KarenStirling for July 2013 Achievements in Last Period
Issues
Next Steps
| ||||||||||||
EST066 (AP12-001) Migration of BEMS Server to Centrally Hosted Infrastructure
Category: Compliance Milestones
RAG Status RED | Report by Sue Woodger for July 2013
Achievements in Last Period
IssuesAn unexpected issue was encountered in the days leading up the scheduled Disaster Recovery tests at the end of July. ITI Architecture advised that here was a security issue with reinstating the system at the secondary site (AT) using the same server IP address as used at the primary site. It is vitally important that the same IP addess is used as all the outstandings are pre-coded with that server IP address. Whilst a Disaster Recovery test had been previously undertaken, it has transpired that the DR machine used for the test had not been situated as requested at the secondary site, but at the primary site. A meeting has been arranged with ITI Architecture week beginning 12 August to resolve the issue and determine how ITI Architecture will take this forward Next Steps
| ||||||||||||
EST071 (AP23-038) Waste Management
Funded
Milestones
RAG Status GREEN | Report by Andrew Stewart for July 2013
Achievements in Last Period During the past month;
. Issues
Next Steps
As the project has been re-planned and is about to enter full user acceptance testing the project rag status has returned to Green |
Section Four: Closed or Withdrawn Projects
| Project Info | Project Managers Commentary |
AP12-033 Lean - Improvements to Repairline and Ordering/Billing Processes Discretionary | Report by Andrew Stewart This project was closed/withdrawn on 26-October-12 Please see the PRICCL log for further details |
EST065 (AP90-030) Lease Sales Invoice to EFin Sales Ledger Morna Findlay Funded | The project deployed to LIVE on 11 December 2013 The Deployment Review was held on 15 January 2013 The Closure Review Was held on 28 January 2013 The project was closed on 28/1/2013 |
EST069 (AP12-016) Archibus Upgrade Stevie Conlon Category: Compliance | The project was closed on 14th June |
EST072 (AP12-016) Energy Recording Systems Upgrade Anne Mathison Category: Compliance | The EST072 Project was deployed to LIVE on 7-May-13 The Deployment Sign Off Review and Closure was held on 3-Jun-13 The project was closed on 14th June |
EST073 (AP23-039) Security Incident Tracking System Andrew Stewart Category: Funded | The project was closed on 2nd August 2013 |
Section Five: Programme Meeting Minutes
| Date | Activity |
| 12/08/13 | Programme Meeting minutes |
